Whole Home Renovation Timeline

Table of Contents
Whole-Home-Renovation-Timeline

A whole home renovation in Sydney typically takes between 16 and 52 weeks depending on property size, scope of work, and council approval requirements. That range is wide for a reason. Every home carries its own structural history, compliance needs, and design complexity.

Whether you are gutting a two-bedroom apartment in the Inner West or transforming a four-bedroom family home on the North Shore, understanding the real timeline before you commit protects your budget, your sanity, and your end result. Delays cost money. Rushed decisions cost more.

This guide breaks down every phase of a whole home renovation, the factors that stretch or compress your schedule, how to align your budget with each stage, and the mistakes that catch Sydney homeowners off guard. If you are planning a full renovation, this is your roadmap.

What Is a Whole Home Renovation Timeline?

A whole home renovation timeline is the complete schedule of works required to renovate an entire property from start to finish. It covers every stage, from initial design and council approvals through demolition, structural work, fit-outs, and final handover. Unlike a single-room project, a whole home renovation coordinates multiple trades, overlapping phases, and sequential dependencies across the entire dwelling.

The timeline is not just a calendar. It is a project management tool that determines when money is spent, when trades arrive on site, and when decisions need to be locked in. Getting it wrong means budget blowouts, idle tradespeople, and months of unnecessary disruption.

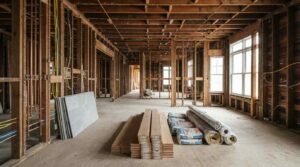

House under renovation with exposed timber framing, electrical wiring, insulation materials, and stacked flooring inside an unfinished interior

How a Full Home Renovation Differs from Partial Upgrades

A bathroom renovation or kitchen upgrade operates in relative isolation. You are working within one room, with a contained set of trades and a predictable sequence. A whole home renovation is fundamentally different. It involves system-wide changes to plumbing, electrical, structural framing, and sometimes the building envelope itself.

When you renovate an entire home, every phase depends on the one before it. Plumbing rough-in cannot start until demolition is complete. Plastering cannot begin until electrical and plumbing are signed off. Kitchen and bathroom fit-outs wait for waterproofing cures. This sequential dependency is what makes the timeline both longer and more sensitive to disruption than any single-room project.

The coordination challenge also multiplies. Instead of managing two or three trades, a full renovation may require ten or more, including demolishers, structural engineers, plumbers, electricians, plasterers, waterproofers, tilers, carpenters, painters, and specialist installers. Scheduling these trades in the correct order, with minimal downtime between them, is the core skill of effective renovation project management.

Why Sydney Renovations Follow a Different Timeline

Sydney’s renovation environment introduces variables that do not exist in many other Australian markets. Council approval processes vary significantly between local government areas. A Development Application (DA) in one council might take six weeks. In another, it could take sixteen. Complying Development Certificates (CDCs) offer a faster pathway for qualifying projects, but not every renovation scope fits within CDC parameters.

Heritage overlays, bushfire zones, flood mapping, and strata regulations all add layers of compliance that directly affect how long the planning phase takes. SafeWork NSW requires licensed asbestos assessors for any demolition of homes built before 1990, adding a mandatory compliance step that affects project scheduling across much of Sydney’s older housing stock. Sydney’s construction market is also one of the most competitive in Australia. Trade availability fluctuates with demand, and material supply chains serving the Sydney basin can experience bottlenecks, particularly for imported tiles, stone, and custom joinery.

Weather plays a role too. Sydney’s wet season can delay external work, roofing, and any phase that requires dry conditions for curing or sealing. Planning your renovation start date around these seasonal patterns is a practical decision, not just a preference.

Typical Whole Home Renovation Timeline in Sydney

The total duration of a whole home renovation depends on three primary variables: property size, scope of structural work, and the speed of council approvals. Below are realistic ranges based on common Sydney renovation projects.

Small Homes and Apartments (8–16 Weeks)

A one- or two-bedroom apartment or small freestanding home with a cosmetic-to-moderate renovation scope typically falls in the 8 to 16 week range for construction. This assumes planning and approvals are handled beforehand. Projects in this category usually involve a single bathroom, a compact kitchen, new flooring, painting, and updated electrical and plumbing within existing layouts.

Strata properties add a layer of scheduling complexity. Body corporate approval, building access restrictions, and noise-permitted hours can extend the effective construction window. An apartment building that only permits construction between 8 am and 4 pm on weekdays costs your trades productive hours compared to a freestanding home with no such restrictions.

Mid-Size Family Homes (16–30 Weeks)

Three- to four-bedroom homes undergoing a full renovation including kitchen, one or two bathrooms, living areas, flooring, painting, and potentially a layout reconfiguration typically require 16 to 30 weeks of construction time. Add 4 to 12 weeks on top for the planning and approval phase.

This is the most common category for Sydney whole home renovations. The timeline stretches when structural walls are removed, when home extensions are added, or when the home requires re-roofing or re-stumping. Projects that stay within the existing footprint and do not require a DA tend to sit at the shorter end of this range.

Large or Heritage Properties (30–52+ Weeks)

Large homes, multi-storey renovations, and heritage-listed properties regularly exceed 30 weeks of construction. Heritage work in particular introduces specialist trades, conservation requirements, and additional council oversight that can double the planning phase alone.

Properties over 250 square metres with full gut renovations, new wet areas, structural modifications, and external landscaping should budget for a 12-month total project timeline from first design meeting to final handover. This is not pessimistic. It is realistic for Sydney’s regulatory and construction environment.

Home renovation showing an unfinished wall with exposed framing and wiring beside a completed modern kitchen with a marble island

Phase-by-Phase Breakdown of a Whole Home Renovation

Every whole home renovation follows a predictable sequence of phases. Understanding what happens in each phase, how long it takes, and what decisions you need to make before it starts is the single most effective way to keep your project on track.

Phase 1: Planning, Design, and Council Approvals (4–12 Weeks)

This is the phase most homeowners underestimate. Before any physical work begins, you need architectural or building design drawings, engineering reports for any structural work, a scope of works document, and either a CDC or DA approval from your local council.

For projects that qualify as Complying Development, a private certifier can issue approval in as little as two to four weeks. Development Applications submitted to the NSW Planning Portal typically take six to sixteen weeks depending on the local government area and whether neighbour notification is required.

During this phase, finalise material selections, obtain fixed-price quotes from builders, and confirm your renovation budget. Every decision you delay here creates a downstream delay during construction.

Key tasks include site surveys, soil testing where required, asbestos inspections for pre-1990 homes, and engagement of a principal certifier. SafeWork NSW requires licensed asbestos assessors for any demolition of homes built before 1990.

Phase 2: Demolition and Structural Work (2–6 Weeks)

Once approvals are in hand, demolition begins. This includes stripping out old kitchens, bathrooms, flooring, wall linings, and any structural elements being modified. Where asbestos is present, licensed removal must occur before general demolition can proceed, adding one to two weeks depending on the extent.

Structural work follows immediately. This covers steel beam installation for wall removals, new framing for layout changes, subfloor repairs, and any foundation work. A structural engineer must sign off on beam sizes and connection details before framing can proceed.

For mid-size Sydney homes, demolition and structural work combined typically takes two to six weeks. Removing a single load-bearing wall with a steel beam is a three-day job. Reconfiguring an entire floor plan with multiple structural modifications takes considerably longer.

Phase 3: Rough-In: Plumbing, Electrical, and HVAC (2–4 Weeks)

Rough-in is the phase where all are installed within walls, floors, and ceilings before they are closed up. Plumbers run new water supply lines, waste pipes, and gas lines. Electricians install wiring, switch plates, and circuit boards. HVAC installers run ductwork for air conditioning or heating systems.

This phase requires precise coordination. Plumbing and electrical rough-in often happen simultaneously, but each trade needs clear access to wall cavities and ceiling spaces. Scheduling conflicts here are one of the most common causes of short delays in residential renovations.

All rough-in work must pass inspection before the next phase can begin. In NSW, plumbing and electrical work requires sign-off from licensed practitioners, and your principal certifier will conduct progress inspections at this stage.

Phase 4: Framing, Insulation, and Plastering (2–4 Weeks)

With roughed-in and inspected internal framing completed, insulation is installed in external walls and ceilings, and plasterboard goes up. This phase transforms the construction site from an open shell into recognisable rooms.

Plastering includes hanging plasterboard, taping joints, applying setting compound, and sanding to a smooth finish. Wet areas require specific plasterboard products rated for moisture exposure. Ceilings, cornices, and any decorative plaster details are completed during this phase.

Drying and curing times matter here. Setting compound needs adequate time to dry between coats, and rushing this step results in visible defects that are expensive to fix after painting. In Sydney’s humid months, allow extra drying time.

Phase 5: Kitchen and Bathroom Fit-Outs (3–6 Weeks)

This is the phase where the renovation starts to look like a finished home. Bathroom waterproofing is applied and must cure for a minimum period before tiling begins. Kitchen cabinetry is installed, followed by benchtops, splashbacks, and appliance connections.

Bathroom fit-outs follow a strict sequence: waterproofing, tiling, fixture installation, and then glass screens or shower enclosures. Each step has a mandatory waiting period. Waterproofing membranes in NSW must comply with AS 3740 and require inspection before tiling.

Renovating multiple bathrooms and a kitchen simultaneously allows this phase to run in parallel across different rooms, compressing the overall timeline. That approach requires enough tradespeople on site to maintain progress without bottlenecks.

Material lead times are critical here. Custom vanities, stone benchtops, imported tiles, and specialty tapware can take 4 to 12 weeks to arrive after ordering. Items not ordered during the planning phase are where the timeline stalls.

Phase 6: Flooring, Painting, and Interior Finishes (2–4 Weeks)

Flooring installation, internal painting, and finish carpentry happen in this phase. The sequence matters. Painting typically happens before flooring to avoid drips and spills on new surfaces. Skirting boards, architraves, door hardware, and built-in joinery are installed after painting.

Flooring options each carry different installation and curing timelines. Engineered timber can be laid and walked on within 24 hours. Polished concrete requires grinding, sealing, and extended curing. Large-format floor tiles need careful substrate preparation and longer setting times.

This phase also includes installation of light fittings, power point covers, towel rails, mirrors, and all the small details that complete each room. These items seem minor individually, but collectively they represent dozens of installation tasks that need to be scheduled and completed.

Phase 7: Final Inspections, Defects, and Handover (1–2 Weeks)

The final phase covers the Occupation Certificate inspection, defect identification, and rectification. Your principal certifier will conduct a final inspection to confirm all work complies with the approved plans and the Building Code of Australia. The Occupation Certificate is the legal document that confirms the building is safe and suitable for habitation; without it, the project is not formally complete.

A defect walkthrough with your builder identifies any items that need correction. Common defects include paint touch-ups, minor tile grout repairs, door adjustments, and appliance commissioning. Under the Home Building Act 1989 (NSW), a reputable builder addresses these within the statutory defect liability period of 13 weeks for minor defects and 2 years for major defects.

Handover includes receiving all warranties, compliance certificates, trade contact details, and maintenance instructions for installed products. This documentation is important for insurance, future resale, and ongoing property management.

Key Factors That Affect Your Renovation Timeline

No two whole home renovations run on exactly the same schedule. The following factors are the most common reasons Sydney projects run longer than initially expected.

Council Approvals and DA Processing in Sydney

Council processing times are outside your builder’s control and often outside your architect’s control. Sydney councils each maintain their own assessment timelines, and these can shift based on staffing levels, application volumes, and the complexity of your proposal.

A CDC through a private certifier is the fastest approval pathway, typically two to four weeks. A DA submitted to council ranges from six to sixteen weeks for straightforward applications. Projects that trigger heritage review, tree preservation orders, or neighbour objections require additional weeks for assessment and potential modification.

Start the approval process as early as possible. Do not sign a construction contract with a start date that assumes approval will arrive on time. Build a buffer.

Strata Renovation Approvals and Body Corporate Requirements

Strata renovations carry an additional approval layer that freestanding home renovations do not. Before any licensed contractor sets foot on site, the owners corporation must approve the scope of works, the contractor’s insurance, and the construction methodology. This process is governed by the Strata Schemes Management Act 2015 (NSW) and can take four to eight weeks depending on how frequently the owners corporation meets.

Noise restrictions, waste removal rules, and lift access bookings all add scheduling constraints that compress your effective working hours. Factor these into your construction program from day one, not as an afterthought.

Scope Changes and Design Revisions

Changing your mind during construction is the single most expensive and time-consuming thing you can do. Every scope change requires reassessment by the builder, potential re-quoting from trades, possible re-ordering of materials, and sometimes re-approval from your certifier.

Moving a bathroom door by 300mm sounds minor. In practice, it may require re-routing plumbing, adjusting waterproofing, modifying framing, and re-tiling. That one change can add a week to the schedule and thousands to the budget.

Lock in your design, selections, and layout before construction begins. Resolve every decision during the planning phase when changes cost nothing.

Material Lead Times and Supply Chain Delays

Imported materials are a common timeline risk for Sydney renovations. Italian or Spanish floor tiles, custom stone benchtops, European tapware, and bespoke joinery all carry lead times that range from 4 to 16 weeks depending on the supplier and country of origin.

Domestic materials are generally faster, but not immune to delays. Popular tile ranges sell out. Benchtop fabricators have booking queues. Appliance models go on backorder.

Finalise all materials during the planning phase and place orders before construction begins. Your builder should provide a materials schedule that maps delivery dates to the construction program.

Heritage Overlay Requirements and Conservation Trades

Heritage-listed properties and homes within heritage conservation areas face requirements that standard renovations do not. The NSW Heritage Act 1977 and individual council heritage development control plans govern what can be altered, what must be retained, and what materials are permissible. Conservation work requires specialist trades: heritage plasterers, lime mortar specialists, and period joinery fabricators whose availability is limited and whose lead times are long.

The heritage assessment and approval process alone can add eight to sixteen weeks to the planning phase. Budget for it explicitly. Treating heritage compliance as an afterthought is one of the most reliable ways to blow a renovation timeline.

Weather and Seasonal Considerations in NSW

Sydney receives the bulk of its rainfall between January and March. External work, including roofing, cladding, external painting, and concrete pours, is vulnerable to wet weather delays during these months.

Internal work is less affected, but prolonged wet periods can delay material deliveries, restrict site access, and slow curing times for adhesives, sealants, and coatings.

Starting a whole home renovation in late autumn or early winter allows the most weather-sensitive phases demolition and structural work to occur during Sydney’s driest months. By the time wet season arrives, the project is typically under roof and focused on internal fit-outs.

Contractor Availability and Trade Scheduling

Sydney’s residential construction market operates at high capacity for much of the year. Experienced plumbers, electricians, tilers, and carpenters are in demand, and their availability dictates your construction schedule as much as any other factor.

A well-organised builder maintains relationships with reliable trade teams and books them in advance based on the construction program. A builder scrambling to find a tiler two days before tiling is due to start is a red flag.

Ask your builder how they manage trade scheduling before you sign a contract. A clear construction program with named trades and confirmed booking dates is a sign of professional project management.

Asbestos, Structural Surprises, and Hidden Issues

Pre-1990 Sydney homes have a high probability of containing asbestos in eaves, wet area linings, floor tiles, and cement sheeting. Licensed asbestos removal is mandatory and adds time and cost to the demolition phase.

Beyond asbestos, older homes can reveal termite damage, inadequate foundations, non-compliant wiring, corroded plumbing, and structural deficiencies that only become visible once walls and floors are opened up. These discoveries are not failures of planning. They are inherent risks of renovating older properties.

A pre-renovation building inspection reduces surprises but cannot eliminate them entirely. Budget both time and money for the unexpected. A contingency of 10 to 15 percent of your total budget is standard practice for whole home renovations in Sydney.

Calculator, architectural blueprints, wood flooring sample, and house keys on a marble kitchen island in a modern kitchen

How to Build a Realistic Renovation Budget Around Your Timeline

Your renovation timeline and your budget are directly connected. Understanding when money is spent during a renovation helps you plan cash flow, avoid payment disputes, and make informed decisions about where to invest and where to economise.

Aligning Costs with Each Renovation Phase

Renovation costs do not distribute evenly across the timeline. The planning phase involves design fees, engineering fees, and council application costs, typically 8 to 12 percent of the total project budget.

Demolition and structural work account for 10 to 15 percent. Rough-in adds another 10 to 15 percent. The bulk of expenditure, often 40 to 50 percent, occurs during the fit-out phases when kitchens, bathrooms, flooring, and finishes are installed. Final inspections and defect rectification represent a small percentage but should not be overlooked.

Understanding this distribution helps you plan progress payments with your builder. Most Sydney builders use a progress payment schedule tied to phase completion milestones, which aligns cash outflow with actual work delivered.

Renovation PhaseTypical Budget AllocationTimeline Position
Planning, Design, Approvals8–12%Weeks 1–12
Demolition and Structural10–15%Weeks 13–18
Rough-In10–15%Weeks 19–22
Framing, Insulation, Plastering8–10%Weeks 23–26
Kitchen and Bathroom Fit-Outs25–35%Weeks 27–32
Flooring, Painting, Finishes10–15%Weeks 33–36
Final Inspections and Handover2–5%Weeks 37–38
Contingency10–15%As needed

Renovation Cost Per Square Metre in Sydney

Sydney whole home renovation costs vary significantly by finish tier. As a working benchmark, budget-tier renovations using standard fixtures, domestic tiles, and off-the-shelf cabinetry typically run $1,500 to $2,200 per square metre for construction costs. Mid-range renovations with stone benchtops, semi-custom joinery, and quality tapware sit between $2,200 and $3,500 per square metre. High-end renovations with imported materials, bespoke joinery, and premium appliances regularly exceed $3,500 per square metre.

These figures cover construction only. Design fees, engineering, council applications, and landscaping sit on top. Use them as a cross-check against your builder’s quote, not as a substitute for a fixed-price contract.

How Progress Payment Schedules Work

A progress payment schedule ties your cash outflow to verified construction milestones rather than calendar dates. Under the Home Building Act 1989 (NSW), residential building contracts over $20,000 must include a payment schedule that specifies when each payment is due and what work it corresponds to.

Typical milestones include deposit on signing, frame completion, lock-up, fixing stage, and practical completion. Never pay ahead of the milestone. Paying in advance of completed work removes your leverage and is one of the most common precursors to disputes. Confirm that each milestone is independently verifiable before releasing funds.

Labour Costs and How Timing Impacts Pricing

Labour represents 35 to 45 percent of most whole home renovation budgets in Sydney. Trade rates fluctuate based on demand, and peak construction periods, typically spring and early summer, can see higher quotes due to trade availability pressure.

Engaging a builder during quieter periods, such as late autumn or winter, may result in more competitive pricing and better trade availability. This is not guaranteed, but it is a pattern observed across the Sydney residential market.

Fixed-price contracts protect you from labour cost escalation during the project. Ensure your contract specifies a fixed price for the agreed scope, with a clear variation process for any changes.

Contingency Budgets: How Much to Set Aside and When

A contingency budget is not optional for a whole home renovation. It is essential. The industry standard recommendation is 10 to 15 percent of the total construction cost, held in reserve for unforeseen issues.

Common contingency triggers include asbestos discovery, structural deficiencies, plumbing or electrical non-compliance, and material price increases for long-lead items. In a whole home renovation, the probability of encountering at least one of these issues is high.

Release contingency funds only for genuine unforeseen costs, not for scope additions or upgrade decisions. Reaching the end of your renovation without using the full contingency means that money is available for landscaping, furnishing, or simply retained as savings.

Financing a Whole Home Renovation in Sydney

Most Sydney homeowners fund whole home renovations through one of three mechanisms: equity release via a home loan top-up or redraw facility, a construction loan drawn down in stages as work progresses, or a personal loan for smaller scopes. Construction loans are structured to align with progress payment milestones, which makes them well-suited to larger renovations where cash flow timing matters.

Speak to your lender before signing a building contract. Lenders assess renovation loans differently from standard mortgages, and approval timelines can add four to eight weeks to your pre-construction phase. Factor this into your overall project schedule.

How to Keep Your Whole Home Renovation on Schedule

Staying on schedule requires proactive management, not reactive problem-solving. The following strategies are used by experienced builders and informed homeowners to minimise delays.

Choosing the Right Builder and Project Manager

Your builder is the single most important factor in timeline adherence. A builder with a structured project management approach, established trade relationships, and a track record of completing projects on schedule is worth more than the cheapest quote.

Ask prospective builders for a sample construction program. This document should show each phase, its duration, trade assignments, and dependencies. A builder who cannot produce this before signing a contract is unlikely to manage your timeline effectively during construction.

Check references specifically for timeline performance. Ask previous clients whether the project finished on time, how delays were communicated, and how variations were managed.

How to Read a Builder’s Construction Program

A construction program is a Gantt-style schedule that maps every phase, trade, and milestone across the project duration. Each task has a start date, a finish date, and a dependency, meaning it cannot begin until a preceding task is complete. The gap between the earliest a task can finish and the latest it can finish without delaying the project is called float. Tasks with zero float are on the critical path; any delay to them delays the entire project.

When reviewing a construction program, look for realistic durations (not compressed to win the job), named trades against each phase, and clear dependencies between tasks. A program that shows every phase running in parallel with no dependencies is not a real construction program. It is a sales document.

Owner-Builder vs Licensed Builder: What Sydney Law Requires

An owner-builder permit in NSW allows a homeowner to act as their own principal contractor for work on their primary residence. Under the Home Building Act 1989 (NSW), owner-builder permits are only available for work valued over $10,000 and require completion of an approved course. The permit is limited to one property per five-year period.

The practical reality is that owner-builders take on full legal responsibility for compliance, safety, and defect rectification without the statutory warranty protections that apply to licensed builder contracts. For a whole home renovation, the coordination complexity and compliance exposure make a licensed builder the lower-risk choice for the vast majority of Sydney homeowners.

Locking In Materials and Selections Early

Every material selection you delay is a potential timeline delay during construction. Tiles, tapware, vanities, benchtops, appliances, flooring, and light fittings should all be selected and ordered before construction begins.

Create a selections schedule during the planning phase. Your builder or designer should provide a list of every item that needs to be chosen, the date by which it must be ordered, and the expected delivery lead time. Work through this list methodically and make final decisions. Provisional selections that change later cause re-ordering, restocking fees, and schedule disruption.

Temporary Accommodation and Living Arrangements

Living in a home during a full renovation is not practical or safe for most phases. Demolition, disconnected dust, and active construction make the property unsuitable for habitation from Phase 2 through to the final weeks of Phase 6. Most Sydney homeowners arrange temporary accommodation for the full construction period.

Budget for temporary accommodation as a project cost, not an afterthought. For a 16 to 30 week renovation, short-term rental costs in Sydney can add $15,000 to $40,000 to the total project spend depending on location and property size. Some homeowners negotiate a staged handover with their builder moving back into completed sections while work continues elsewhere, but this requires careful planning and is only viable in larger homes.

Communication Milestones and Progress Check-Ins

Regular communication between you and your builder prevents small issues from becoming large delays. Establish a communication rhythm at the start of the project. Weekly site meetings or progress reports are standard for whole home renovations.

Each progress update should cover work completed since the last update, work planned for the coming week, any issues or decisions required, and the current status relative to the construction program. This transparency allows you to identify emerging delays early and make timely decisions.

What to Do When Delays Happen

Delays are not always avoidable. Weather events, material shortages, and unforeseen site conditions can disrupt even the best-managed projects. What matters is how delays are managed.

Your builder should notify you of any delay as soon as it is identified, explain the cause, quantify the impact on the overall timeline, and propose a recovery plan. Delays caused by something outside the builder’s control, such as weather or council processing, should be covered by time extension provisions in your contract.

Delays caused by the builder’s poor scheduling or trade management are a performance issue that should be addressed directly. A clear contract with defined completion dates and delay provisions protects both parties.

Tile samples and a tape measure on the floor of a room undergoing home renovation with exposed wall framing and construction tools

Common Timeline Mistakes Sydney Homeowners Make

Certain mistakes appear repeatedly in Sydney whole home renovations. Recognising them before you start helps you avoid them.

Underestimating the Planning Phase

Many homeowners want to start demolition as quickly as possible. This urgency often leads to starting construction before designs are finalised, approvals are granted, or materials are ordered. The result is almost always a longer total project duration than if the planning phase had been given adequate time.

Invest the time upfront. A thorough planning phase of 8 to 12 weeks for a whole home renovation is not excessive. It is the foundation of an efficient construction phase.

Starting Without Fixed Selections

Beginning construction with provisional allowances instead of fixed material selections is a common source of budget and timeline blowouts. Without chosen tiles, your tiler cannot be booked with confidence. Without a decided benchtop material, your kitchen installer cannot confirm templating dates.

Fixed selections before construction starts. No exceptions.

Skipping Pre-Renovation Inspections

A pre-renovation building and pest inspection costs a few hundred dollars. Discovering termite damage, asbestos, or structural deficiencies during construction costs thousands and adds weeks.

For any Sydney home built before 1990, an asbestos survey is particularly important. For any home over 30 years old, a pre-renovation structural assessment of subfloor, framing, and roofing should be conducted before finalising your renovation scope and budget.

Whole Home Renovation Timeline Checklist

Use this checklist to track your progress through each phase of a whole home renovation.

Planning Phase

  • Engage an architect or building designer
  • Complete site survey and soil testing (if required)
  • Commission asbestos inspection (pre-1990 homes)
  • Finalise design drawings and specifications
  • Obtain engineering reports for structural work
  • Submit CDC or DA application
  • Finalise all material selections
  • Order long-lead items (tiles, stone, joinery, tapware)
  • Obtain and compare fixed-price builder quotes
  • Sign construction contract
  • Appoint principal certifier
  • Confirm temporary accommodation arrangements
  • Arrange renovation finance if required

Construction Phase

  • Demolition and asbestos removal (if applicable)
  • Structural work and engineering sign-off
  • Plumbing and electrical rough-in
  • Rough-in inspections passed
  • Framing, insulation, and plasterboard
  • Waterproofing application and inspection
  • Tiling in wet areas
  • Kitchen cabinetry and benchtop installation
  • Flooring installation
  • Internal painting
  • Fixture and fitting installation
  • Final carpentry and joinery

Completion Phase

  • Builder defect walkthrough
  • Defect rectification
  • Final certifier inspection
  • Occupation Certificate issued
  • Handover of warranties and compliance documents
  • Final payment per contract terms

Conclusion

A whole home renovation in Sydney is a complex, multi-phase project that demands careful planning, realistic timelines, and disciplined budget management. From council approvals and trade coordination to material lead times and contingency planning, every decision you make during the planning phase directly impacts how smoothly construction runs.

The difference between a renovation that finishes on time and on budget and one that spirals into delays and cost overruns almost always comes down to preparation. Locking in your design, selections, and builder before construction starts gives you the strongest possible foundation for a successful project.

At Sydney Home Renovation, we guide homeowners and property investors through every phase of the renovation timeline with transparent pricing, structured project management, and clear communication. Contact our team today to discuss your project scope, timeline, and budget, and work with a contractor who builds on honesty and delivers on promises.

Frequently Asked Questions

How long does a whole home renovation take in Sydney?

A whole home renovation in Sydney typically takes 16 to 52 weeks of construction time, depending on property size and scope. Add 4 to 12 weeks for the planning and approval phase. Smaller apartments sit at the shorter end, while large or heritage properties can exceed 12 months total.

What is the most time-consuming phase of a full renovation?

The planning and approval phase is often the longest single phase, taking 4 to 12 weeks or more where a DA is required. During construction, kitchen and bathroom fit-outs typically take the most time at 3 to 6 weeks due to waterproofing curing, tiling, and fixture installation sequences.

Do I need council approval for a whole home renovation in Sydney?

Most whole home renovations require either a Complying Development Certificate (CDC) or a Development Application (DA). A CDC is faster and issued by a private certifier. A DA goes through your local council. The approval pathway depends on your property’s zoning, heritage status, and the scope of proposed work.

How much does a whole home renovation cost in Sydney?

Whole home renovation costs in Sydney vary widely based on scope, size, and finish level. A mid-range full renovation of a three-bedroom home typically ranges from $150,000 to $350,000 or more. High-end renovations with premium finishes, structural changes, and extensions can exceed $500,000.

Can I live in my house during a whole home renovation?

Living in a home during a full renovation is not practical or safe for most phases. Demolition, dust, disconnection, and construction activity make the property unsuitable for habitation during most of the construction period. Most homeowners arrange temporary accommodation for the duration.

What causes the biggest delays in home renovations?

The most common delay causes are slow council approvals, late material selections, supply chain delays for imported products, scope changes during construction, and discovery of asbestos or structural issues. Poor trade scheduling by the builder is another frequent contributor.

When is the best time of year to start a renovation in Sydney?

Late autumn and early winter are generally the best times to start a whole home renovation in Sydney. This timing allows demolition and structural work to occur during drier months, with internal fit-outs progressing through the wetter January to March period when the project is under roof.

Facebook
X
LinkedIn
Pinterest

Related Posts

Laundry Room Storage Ideas

Laundry Room Storage Ideas: Cabinets & Shelves

Laundry room storage ideas specifically cabinets and shelves are the single biggest factor in whether a

Compact modern laundry room with stacked appliances, custom storage cabinetry, and space-saving design ideas for maximising functionality in a small home.

Small Laundry Design Ideas to Maximise Space

A small laundry does not have to feel cramped the right design turns even two square

Respirator mask, safety goggles, and asbestos disposal bags prepared for safe asbestos removal work.

Asbestos Removal During Renovation: Process and Regulations

Asbestos removal during a renovation is not optional, it is a legal obligation in NSW, and
