A standard kitchen renovation in Sydney takes between five and eight weeks from demolition to handover, depending on the scope of work, trade availability, and material lead times. Knowing what happens each week, and in what order, is the single most effective way to avoid delays, manage expectations, and stay in control of your project from day one. Understanding the sequence of trades, inspections, and installations helps you ask the right questions before work begins, and this guide walks through every stage week by week, covering what to expect, what can go wrong, and how to keep your project moving forward.
Kitchen Renovation Timeline at a Glance
| Week | Stage | Key Trades | Key Milestone |
| Pre-construction | Planning, approvals, materials | Scope locked, materials ordered | |
| Week 1 | Demolition and site preparation | Demolition crew | Kitchen stripped to shell |
| Week 2 | Rough-in trades | Plumber, electrician, framer | Services repositioned, walls open |
| Week 3 | Waterproofing, insulation, wall prep | Waterproofer, plasterer | Inspection sign-off obtained |
| Week 4 | Cabinetry, benchtops, tiling | Cabinet installer, tiler, stonemason | Benchtops templated, tiling complete |
| Week 5 | Appliances, splashbacks, fit-off | Plumber, electrician, glazier | Kitchen functionally complete |
| Week 6 | Final fixes, painting, handover | Painter, all trades | Defect inspection passed, handover |
What to Expect Before Your Kitchen Renovation Starts
The work that happens before a single tile is removed often determines whether your renovation runs smoothly or stalls. Pre-renovation planning covers scope definition, budgeting, council approvals (where required), material selection, and contractor engagement, and each of these needs to be resolved before your start date is locked in.
Setting a Realistic Budget and Scope
Your budget and scope are directly linked. A kitchen renovation in Sydney can range from $15,000 for a cosmetic refresh to $60,000 or more for a full structural reconfiguration with premium finishes. The scope, whether you are moving plumbing, changing the layout, or simply replacing cabinetry in the existing footprint, determines which trades are required and how long each stage takes.
Locking in your scope before signing a contract prevents variation orders mid-project, which are one of the most common causes of budget blowouts and timeline extensions.
Choosing Your Contractor and Locking In Dates
Your contractor’s availability, trade network, and project management approach will shape your timeline more than any other single factor. A well-organised contractor will provide a detailed schedule showing when each trade is booked, when materials need to be on site, and when inspections are required. Before engaging anyone, verify their licence, check references, and compare at least three detailed quotes.
Once your contractor is engaged, confirm your start date in writing and align it with your material delivery schedule. Cabinetry, benchtops, and appliances often have lead times of two to six weeks, and ordering late is one of the most avoidable causes of project delays.
Pre-Renovation Checklist
Before your contractor arrives on site, confirm the following are resolved:
- Scope of work finalised and signed off in the contract
- All material selections made (cabinetry, benchtops, tiles, appliances, splashback)
- Appliance and benchtop lead times confirmed with suppliers
- Council approval status confirmed (see section below)
- Trade bookings locked in with your contractor
- Contingency budget of 10 to 15 percent set aside
Council Approvals and Exempt Development
Most kitchen renovations in Sydney are classified as exempt development under the State Environmental Planning Policy (Exempt and Complying Development Codes) 2008, meaning no council approval is required. This applies when the work does not involve structural changes, alterations to the building envelope, or changes to the external appearance of the property.
Work that falls outside exempt development, such as removing a load-bearing wall or altering the roofline, requires a Development Application (DA) or a Complying Development Certificate (CDC). We confirm the approval pathway for every project before work begins, because starting without the correct approval can result in stop-work orders and costly rectification.
All electrical and plumbing work requires a licensed tradesperson regardless of approval status, and compliance certificates are issued at completion. Some projects also require a private certifier for mandatory inspection stages under the Building Code of Australia.
Week 1: Demolition and Site Preparation
Demolition is typically the fastest stage of a kitchen renovation, but it sets the condition of everything that follows. Our team strips the kitchen back to the structural shell, removing cabinetry, benchtops, appliances, flooring, wall linings, and ceiling fixtures, while protecting adjacent areas from dust and debris.
What Gets Removed First
Appliances and freestanding items are disconnected and removed first. Cabinetry follows, then wall tiles and splashbacks, then flooring. If the ceiling is being altered or recessed lighting repositioned, ceiling linings come down at this stage too. The sequence matters because each removal exposes the substrate that the next trade will work on.
Structural Checks and Hidden Surprises
Once the walls and floor are exposed, we assess the condition of the substrate, check for any structural issues, and identify anything that was not visible during the quoting stage. This is when hidden problems, including deteriorated waterproofing, outdated wiring, asbestos in older homes, or unexpected structural elements, are discovered.
In Sydney homes built before 1990, asbestos-containing materials in wall linings, floor adhesives, and ceiling textures are not uncommon. If identified, licensed asbestos removal is required before any further work proceeds, and air monitoring is conducted after removal to confirm the area is safe. This adds time and cost to your project, which is why a contingency allowance of 10 to 15 percent of your total budget is standard practice.

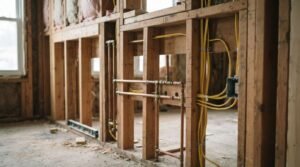

Week 2: Rough-In Trades: Plumbing, Electrical, and Framing
With the kitchen stripped back, the rough-in trade stage begins. This is where our plumber, electrician, and framer work through the space to position services in their new locations before walls are closed up. The order of these trades is coordinated carefully to avoid conflicts and rework, because each trade’s work creates the conditions the next one depends on.
Plumbing Rough-In and Drainage Repositioning
If your new kitchen layout moves the sink, dishwasher, or any water connection to a different position, our plumber repositions the supply lines and drainage at this stage. In a slab-on-ground construction, repositioning drainage requires cutting into the concrete slab, a process that adds time and cost but is straightforward when planned correctly. In homes with a suspended timber floor, drainage repositioning is typically faster and less disruptive.
Rough-in plumbing and electrical work is one of the most variable cost items in any kitchen renovation, and the final price depends on how far services are moving and whether the switchboard requires an upgrade.
Electrical Rough-In and Lighting Layout
Our electrician runs new circuits, positions power points, installs conduit for lighting, and prepares connections for your rangehood, oven, and dishwasher. In Sydney, all electrical work must be carried out by a licensed electrician and is subject to inspection before walls are closed. If you are upgrading to a larger oven or induction cooktop, we confirm early whether your switchboard requires an upgrade, because this is a common source of unexpected cost when left until the fit-off stage.
Week 3: Waterproofing, Insulation, and Wall Prep
Once rough-in trades are complete and inspected, the walls and ceiling are prepared for lining. In kitchen renovations, this stage includes installing insulation where required, patching or replacing wall frames, and applying waterproofing membranes to any wet areas adjacent to the kitchen.
Waterproofing in a kitchen context typically covers the area behind the sink and any wall surfaces that will be exposed to regular moisture. We use a liquid-applied membrane system that is brushed or rolled onto the substrate and requires a minimum cure time before tiling can begin, usually 24 to 48 hours depending on conditions.
Inspection Stages and Sign-Off Requirements
In New South Wales, certain stages of residential building work require a mandatory inspection before the next stage can proceed. We are responsible for scheduling these inspections with the certifier and ensuring the work is ready for sign-off. Delays at this stage, caused by failed inspections or certifier availability, are one of the most common sources of timeline extension in Sydney renovations.
We book inspection stages in advance and do not allow work to proceed past an inspection point without sign-off. Confirm this approach with any contractor before work begins.
Week 4: Cabinetry, Benchtops, and Tiling
Week four is typically the most visually transformative stage of the renovation. Cabinetry installation, benchtop templating, and tiling all happen in close sequence, and the coordination between these trades is critical to keeping the project on schedule.
Cabinet Installation Sequence
Cabinetry is installed in a specific sequence: wall cabinets first, then base cabinets, then tall pantry or appliance cabinets. This sequence ensures that wall cabinets can be fixed to the wall framing without obstruction and that base cabinets are levelled correctly before benchtops are templated. Getting the level right at this stage is non-negotiable, because benchtop fabrication is based on the exact installed position.
Benchtop Templating and Lead Times
Stone benchtops, including engineered stone and natural stone, are templated after cabinetry is installed and fabricated off-site. Fabrication typically takes five to ten business days from templating. This lead time is built into the project schedule, and tiling can proceed in parallel during this window.
Floor and wall tiling begins once cabinetry is in position. The tiler works around the cabinet bases and up to the wall cabinet undersides, leaving the splashback area for installation after benchtops are fitted.
Week 5: Appliance Installation, Splashbacks, and Fit-Off
With benchtops installed and tiling complete, the kitchen begins to take its final form. Week five covers appliance connections, splashback installation, and the fit-off of all fixtures and fittings.
Appliance Connections and Final Trades
Our plumber returns to connect the sink, dishwasher, and any gas appliances. Our electrician connects the oven, cooktop, rangehood, and dishwasher to their dedicated circuits. These connections require a licensed tradesperson and, in the case of gas appliances, a gas-fitting licence. Final trade connections are typically completed in one to two days when trades are coordinated efficiently.
Splashback Installation and Grouting
Splashback material affects both your lead time and your installation sequence. Tile splashbacks are installed after benchtops are in place, then grouted and sealed in the same visit. Glass splashbacks are templated after benchtops are fitted and fabricated off-site, typically requiring five to seven business days, similar to stone benchtops. Stone splashbacks follow the same templating and fabrication process and carry the longest lead time of the three options.
Confirm your splashback material and order it early. A delayed splashback is one of the most common reasons Week 5 extends into Week 6.
Week 6: Final Fixes, Painting, and Handover
The final week of a kitchen renovation covers all finishing work, including painting, hardware installation, touch-ups, and the formal defect inspection before handover.
Defect Checks and Practical Completion
Before handover, we conduct a formal defect inspection with you present. This walkthrough identifies any items that require rectification, including paint touch-ups, grout inconsistencies, hardware alignment, or appliance commissioning issues, before practical completion is declared.
In New South Wales, the Home Building Act 1989 provides statutory warranty protections for residential building work. We are required to rectify any defects identified within the warranty period, and understanding your rights before handover gives you a clear basis for raising any concerns.
Cleaning, Styling, and Final Walkthrough
Once defects are rectified, the kitchen is professionally cleaned and handed over. We provide all relevant documentation at this stage: certificates of compliance for electrical and plumbing work, any inspection certificates, warranty documentation for appliances and materials, and a copy of the final contract with variations noted.
Living Without a Kitchen During the Renovation
Six weeks without a functioning kitchen requires some practical planning. We recommend setting up a temporary kitchen in another room before demolition begins, using a microwave, kettle, and bar fridge as the core setup. A portable induction cooktop adds meaningful cooking capacity for a modest cost.
Protect your temporary kitchen area from dust during demolition and rough-in weeks with plastic sheeting across doorways. Most of our clients find the first two weeks the most disruptive, with conditions improving significantly once cabinetry is installed in Week 4.
Budget for increased takeaway and meal delivery costs during the renovation period. For a six-week project, this is a real but manageable expense that is worth factoring into your overall budget from the outset.
What Can Delay a Kitchen Renovation Timeline
Even well-planned renovations encounter delays. The most common causes in Sydney include material lead times that were not confirmed before the start date, trade scheduling conflicts caused by overlapping projects, failed inspections requiring rework, and hidden structural or hazardous material issues discovered during demolition.
Weather rarely affects kitchen renovations directly, but it can affect trade availability if your contractor’s team is managing multiple outdoor projects simultaneously. Delays in council approvals or certifier availability can also push inspection stages back by days or weeks.
Most timeline delays are preventable. Resolving every material selection, approval, and trade booking before your start date is the single most effective thing you can do to protect your schedule.
How to Keep Your Kitchen Renovation on Schedule
The most effective way to keep a kitchen renovation on schedule is to resolve every decision before work begins. This means finalising your material selections, confirming appliance lead times, locking in trade bookings, and obtaining any required approvals before your start date, not during the project.
Communicate regularly with your contractor throughout the project. A weekly site meeting or progress update gives you visibility over what is happening, what is coming next, and whether any decisions need to be made quickly to avoid delays.
We manage trades, materials, and inspections as a coordinated system on every project we run, because that coordination is what keeps a kitchen renovation on schedule.
Conclusion
A kitchen renovation that runs on schedule is the result of careful planning, coordinated trades, and clear communication, not luck. Understanding the week-by-week sequence gives you the framework to ask the right questions, make decisions at the right time, and hold your contractor accountable at every stage.
The six-week timeline outlined here reflects a standard full kitchen renovation in Sydney. Scope, site conditions, and material choices will influence your actual duration, and building in contingency time is always a sound approach.
We at Sydney Home Renovation manage every stage of your kitchen renovation, from pre-construction planning and trade coordination to final handover, so your project stays on schedule, on budget, and built to last. Contact us today to discuss your timeline.
Frequently Asked Questions
How long does a kitchen renovation take in Sydney?
A standard kitchen renovation in Sydney takes between five and eight weeks from demolition to handover. The exact duration depends on scope, whether plumbing or electrical layouts are changing, material lead times, and trade availability.
What happens during the rough-in stage of a kitchen renovation?
The rough-in stage covers all plumbing, electrical, and framing work before walls are closed. We reposition water supply and drainage lines, run new circuits and conduit, and make any structural adjustments required by the new layout.
Why do benchtops take so long in a kitchen renovation?
Stone benchtops are templated after cabinetry is installed and then fabricated off-site. Fabrication typically takes five to ten business days. This lead time is built into the project schedule, and other trades such as tiling can proceed in parallel during this window.
What are the most common causes of kitchen renovation delays?
The most common causes of delays are material lead times not confirmed before the start date, trade scheduling conflicts, failed inspections requiring rework, and hidden issues discovered during demolition, such as asbestos, deteriorated waterproofing, or outdated electrical wiring.
Do I need council approval for a kitchen renovation in Sydney?
Most kitchen renovations in Sydney are classified as exempt development and do not require council approval, provided the work does not involve structural changes or alterations to the building envelope. All electrical and plumbing work requires licensed tradespeople and compliance certificates regardless of approval status.
What should I receive at kitchen renovation handover?
At handover, you should receive certificates of compliance for all electrical and plumbing work, any mandatory inspection certificates, warranty documentation for appliances and materials, and a copy of the final contract with all variations recorded. A formal defect inspection should be completed with you present before practical completion is declared.
How much contingency should I allow in my kitchen renovation budget?
A contingency allowance of 10 to 15 percent of your total renovation budget is standard practice for kitchen renovations in Sydney. This covers hidden issues discovered during demolition, variation orders, and any scope changes that arise once work is underway.
